CoTec Announces Updated Mineral Resource and Positive Preliminary Economic Assessment for the Lac Jeannine Iron Tailings Project, Québec, Canada

CoTec Announces Updated Mineral Resource and Positive Preliminary Economic Assessment for the Lac Jeannine Iron Tailings Project, Québec, Canada

VANCOUVER, BC / ACCESS Newswire / May 20, 2026 / CoTec Holdings Corp. (TSXV:CTH,OTC:CTHCF)(OTCQB:CTHCF) ("CoTec" or the "Company") is pleased to announce an updated independent Preliminary Economic Assessment ("2026 PEA") for the Lac Jeannine Iron Tailings Project, Québec, Canada ("Lac Jeannine", or the "Project") which includes a new Mineral Resource Estimate (the "2026 MRE") that was developed following the August 2025 drilling programi and is consistent with the previous PEA and Technical Report filed in 2024 ("2024 PEA").ii

The 2026 MRE was prepared byMinéralis Consulting Services ("Minéralis") and the 2026 PEA by independent experts Addison Mining Services Ltd., Axe Mining Solutions Limited, Soutex Inc, JPL GeoServices Inc. and other independent experts.

The highlights of the 2026 MRE and 2026 PEA are as follows:

  • A 41% increase in the resource compared to the 2024 PEA with a global increase in Total Fe grade from 6.7 to 6.8 %FeT.

    Category

    2024 PEA

    2026 PEA

    Tonnage (Mt)

    Total Fe (%)

    Total Fe (Mt Metal)

    Tonnage (Mt)

    Total Fe (%)

    Total Fe (Mt Metal)

    Indicated

    0

    0.0

    31

    6.82

    2.1

    Inferred

    73

    6.70

    4.9

    71

    6.80

    4.9

    (Note: tonnes are metric tonnes, see below for MRE notes)

  • Conversion of 31 Mt of inferred resource into indicated resourced supporting the first four years of production.

  • The 2026 MRE has resulted in extension of the life of mine to 15 years from 11 years with total tonnes of concentrate produced increasing from 3.8 Mt to 5.4 Mt.

  • Following a trade-off study, the proposed mining method has been changed from contract mining, (using trucks and front-end loaders) to a continuous miner with overland conveyors. Capital expenditure ("CAPEX") for the continuous miner is estimated to be US$6.8M with an operating expense ("OPEX") of US$0.65/t mined.

  • Based on open-pit extraction methods and the production of a gravity concentrate via conventional processing techniques and at a discount rate of 7.0% (and based solely on the 2026 MRE), the pre-tax NPV is US$141.5M, and its IRR is 33.8%, and the after tax NPV is US$91.9M, and its IRR is 29.6% with payback achieved in 2.3 years and a profitability index (PI) of 1.2.iii The after tax NPV does not include any potential benefit from government incentives, tax or otherwise.

  • The product remains a high purity iron concentrate at 66.8% FeT, low contaminant SiO2, Al2O3 and phosphorus with an average production of circa 360kt per annum for 15 years.

  • The up-front capital cost is US$69.4M which has increased marginally from the 2024 PEA figure due to the change in mining method.

  • C1 cash costs have decreased to US$46.8/t from the 2024 PEA level of US$53/t (excl. transport to port and royalty payments); this is due to the change in reclamation method which decreased the cost from US$0.9/t mined to US$0.65/t mined and a re-basing of G&A costs from US$0.3/t mined to US$0.25/t mined, which is more in line with other operators in the region with updated input costs.

  • All-in Sustaining Cost (ASIC) is US$54.5/t compared to the 2024 PEA figure of US$61/t (incl. transport to port and royalty payments).

  • The 2026 PEA does not include further tailings that are present outside of the indicated and inferred drilling area of the 2025 drilling campaign and further potential upside from the application of the Salter gravity separation technology that would allow access to the ultra-fine material contained in the tailings.

Julian Treger, CoTec CEO commented; "the updated PEA is a very important step forward for the project as we continue to work through the Bankable Feasibility Study. Achieving 103 million tonnes of mineralized material increases the life of mine to 15 years. This improves the long-term economic opportunity the project offers, not only to CoTec but to the surrounding communities and stakeholders.

In partnership with BBA Consulting of Montreal, CoTec have made significant progress on the project and identified a clear path forward to deliver the Bankable Feasibility Study and obtain the required environmental permits for the project. Through our discussions with our stakeholders, we continue to receive positive support as the Company progresses through the environment baseline studies.

The further optimization work, inclusion of the remaining 28 million tonnes to 40 million tonnes of exploration material and application of the Salter gravity separation technology could potentially add further significant upside. We will also be investigating possible ways to upgrade the FeT content of the concentrate from the current level of 66.8% to 67% iron concentrate suitable for direct reduction iron (DRI) production, which is crucial for green steel production."

Details of 2026 PEA

The 2026 PEA study was undertaken by a multidisciplinary team appointed by CoTec and supported by Minéralis Consulting Services Inc, Axe Valley Mining Consultants Ltd, JPL GeoServices Inc, Amerston Consulting Ltd. and Addison Mining Services Ltd. of the United Kingdom. No changes were made to the process flowsheet; Soutex were not required to update sections 13 and 17 of the 2024 PEA so those sections remain unchanged in the 2026 PEA. A Technical Report for the Project, including the details of the 2026 MRE and its 2026 PEA, will be filed on https://www.sedarplus.ca/ within 45 days.

The key financial and production metrics of the Project are summarized in Table 1. The 2026 PEA did not incorporate prospects for potential economic support from governments, funding opportunities or other economic incentives that could improve economics and influence a future feasibility study ("FS") and investment decision, including those aiming to encourage the development of critical minerals and a circular economy.

Table 1: 2026 PEA Key Financial Metrics in US$

Assumptions

Unit

Mineralized Material

M dmt

103

Project Duration

Years

15

Average annual production (dry)

K tonnes per annum

360

Average FeT In-situ grade to plant

%

6.8

Average FeT metallurgical recovery

%

51.6

Average concentrate grade sold

% Fe

66.8

Economic Assumptionsiv

P65 Index CFR China Iron ore price

US$/dmt

121

Average realised price (Inc. high grade premium)

US$/dmt

145

Average shipping cost

US$/dmt

21

Capital Cost

Construction period

Years

2

Initial CAPEX (excl. closure, study costs and sustaining)

US$ million

69.4

Operating cost per tonne

Total cash cost (C1 Cost)

US$/dmt

46.8

Total AISC

US$/dmt

54.5

The 2026 PEA is preliminary in nature and is based on a combination of Indicated and Inferred Mineral Resources. Inferred Mineral Resources are considered too speculative geologically to have the economic considerations applied to them that would enable them to be categorized as Mineral Reserves. As such, there may be no certainty that the 2026 PEA will be realized.

Basis of 2026 MRE

The MRE is based upon 25 sonic drillholes totalling 1,083 m (ranging between 36.0 m and 57.9 m in depth). All drillholes were drilled vertically and spaced from 100 m to 200 m apart on a regular staggered grid. The internal tube diameter was 4.05 inches. All material was logged for colour and grainsize characteristics, the average drillhole recovery was estimated at 93%. Routine quality control samples were inserted into the sample stream representing 85 out of 698 samples typically of length 1.5 m. Drilling and sampling was directly supervised by Mr John Langton (P.Geo.), Independent Qualified Person for Exploration, Drilling and Data Collection, in September of 2023 and August of 2025.

All drillhole material, minus a small 1.0 to 1.5 litre reference sample were dispatched in clearly labelled bags with sample tickets to Corem, a Québec City-based laboratory for analysis. Corem is internationally accredited by the Canadian Standards Council through the Bureau de Normalization du Québec (BNQ) to ISO/IEC 17025:2017 Analytical Services Laboratory.

All material was recorded upon receipt, and weighed wet and after oven drying. Sub sampling was done by rotary sample splitter before pulverization and preparation of a tungsten fusion bead for XRF analysis of major oxides (SiO₂, Al₂O₃, Fe₂O₃, MgO, CaO, Na₂O, K₂O, TiO₂, MnO, P₂O₅, Cr₂O₃, V₂O₅, ZrO₂, and ZnO) plus Loss on Ignition.

Mineral Resource Statement

Mineral Resources, reported in accordance with National Instrument 43-101, Standards of Disclosure for Mineral Projects, ("NI 43-101") and prepared under Canadian Institute of Mining, Metallurgy and Petroleum ("CIM") Definition Standards, have been estimated for the Project. The MRE is reported inside an optimized open pit shell to respect Reasonable Prospect of Eventual Economic Extraction (RPEEE) and is supported by the 2026 PEA.

The estimated 2026 MRE, reported in accordance with NI 43-101 and the CIM Definition Standards is set out in Table 2 and the accompanying notes for further information and Figure 1 for an overview of the 2026 MRE:

  • Indicated Mineral Resources of 31 Mt at 6.82% FeT for 2.1 Mt of contained FeT.

  • Inferred Mineral Resources of 71 Mt at 6.80% FeT for 4.9 Mt of contained FeT.

Table 2: 2026 Mineral Resource Estimate

Category

Million Tonnes

FeT grade %

FeT (Mt)

Fe2O3%

Indicated

31

6.82

2.1

9.76

Inferred

71

6.80

4.9

9.73

Notes To 2026 MRE:

  1. Numbers are rounded to reflect that an estimate of tonnage and grade has been made, as such products may have discrepancies. Tonnages are expressed in the metric system and metal content as percentages.

  2. The Independent Qualified Person for Mineral Resources, Mr Christian Beaulieu, P.Geo., is a member of l'Ordre des géologues du Québec (#1072). Mr Beaulieu has reviewed the available geological, assay and quality control data and has completed a site visit on the 7th of August 2025. Mr Beaulieu has been an employee of Mineralis Consulting Services Inc. since the 1st of June 2023.

  3. The effective date of the 2026 MRE is the 23th of March 2026.

  4. These Mineral Resources are not Mineral Reserves as they do not have demonstrated economic viability. The quantity and grade of reported Inferred Resources in the 2026 MRE are uncertain in nature. It is reasonably expected that the majority of Inferred Mineral Resources could be upgraded to Indicated Mineral Resources with continued exploration. No Measured Mineral Resources are reported.

  5. The estimate was completed using Leapfrog Edge 2025.3.1 software, a 25 m (east and west) by 3 m (vertical) regular block model was estimated using ordinary kriging of all elements analyzed. The block model was restricted using a wireframe volume generated from airborne drone topographic survey of the current tailings surface, a legacy 1:50k contour map of the pre-tailings situation and bedrock information encountered in drilling.

  6. Drilling reached the bottom of the tailings in seven (7) drillholes and the resource was extrapolated ~10 m below the drillholes that did not reach the bottom.

  7. The cut-off grade used to report the 2026 MRE is 3.4% FeT, based on the following parameters:

    • Iron price of US$ 124/t FOB for a 66.8% Fe concentrate

    • Transport costs all in of US$ 6.32/t conc.

    • Total ROM-based costs of US$ 2.46 /t conc

    • Metallurgical recoveries of 51.56%

    • Royalties of 0.5%

    • No dilution and no mining loss were assumed.

  8. Bulk dry density is assumed to be 1.78 g/cm3 across all tailing material. The density assumption is supported by on-site bulk density measurements and corrected for humidity content.

  9. The Mineral Resource extends from surface to approximately 55 m below surface, it is laterally extensive over an area of approximately 1.25 km from east to west, 1.40 km from north to south and is extrapolated approximately 250 m beyond the limit of the drilling.

  10. CIM Definition Standards for Mineral Resources (2014) and Best Practices Guidelines outline by CIM (2019) have been followed.

  11. The independent Qualified Person for the mineral resource estimate is not aware of any known environmental, permitting, legal, title, taxation, socio‑political, marketing, or other relevant factors that would materially affect the estimate. Mineral resource estimates remain subject to inherent risks and uncertainties, and future factors could materially affect the estimate.

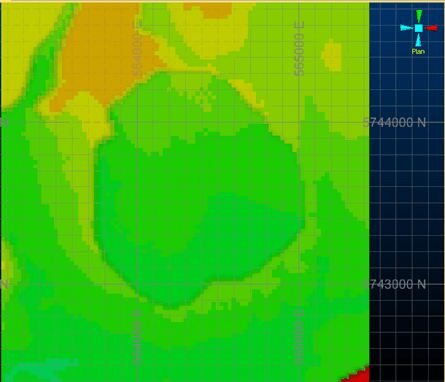

Figure 1: Extents of Mineral Resource relative to drilling and Exploration Target

Exploration Potential

Further tailings are present outside of the drilled area and it is reasonable to expect that with further appropriate exploration drilling the 2026 MRE tonnage could be increased. The surveyed area of the tailings has a total estimated tonnage of 145 million tonnes. This tonnage is likely estimated to relatively close limits (±5 million tonnes); however, iron grades are unknown with only limited sampling of the surface having been completed outside of the drill tested area; not all material may have a reasonable prospect of eventual economic extraction should grades be below economic cut-off, mixed with other waste material or contain significant quantities of deleterious elements.

A study completed by Soutex in 2007v postulated that 154 million tonnes of tailings grading 7.5% FeT were deposited at the Lac Jeannine tailings pile. Soutex's estimate was based on historical production and mass balance records rather than systematic sampling. The results are similar to the findings of this study albeit at a slightly higher grade.

Assuming 70% to 100% of the tailing's material surrounding the Inferred Resource has a similar FeT grade to the 2026 MRE, an exploration target tonnage of 28 Mt to 40 Mt is postulated, with global average FeT grade of 5.9% to 7.7% (±1 SD of the Resource block model) considered a reasonable possibility.

This potential range of tonnes and grade is conceptual in nature. Insufficient exploration to define a Mineral Resource has been completed and it is uncertain if a calculated mineral resource estimate of the surrounding material will be made in the future.

Basis of Preliminary Economic Assessment

Scoping-level design and preliminary economic analysis thereof was undertaken for the Project. The 2026 MRE has been used as a basis for the 2026 PEA.

Mining via open pit methods using a continuous miner and overland conveyor transporter, delivering approximately 7 Mtpa of Run of Mine ("ROM") to stockpile for processing. On site mineral processing is via screening and size classification followed by gravity separation to produce a bulk iron bearing concentrate for sale. Rejected waste material from mineral processing is expected to be disposed of in the legacy Lac Jeannine open pit allowing rehabilitation of the mined parts of the current tailings pile. Preliminary economic analysis has been performed in accordance with the conceptual mine design and schedule, metallurgical testing, and concentrate payability analysis developed in the study, and the estimates and analyses therein have been prepared to scoping level (+-30%). Key Project parameters are presented in Table 3.

Table 3: Summary of Project Parameters

Parameter

Value

Units

Project Production Rate

Mtpa

7.0

Average Strip Ratio

t/t

0.016

Average FeT Grade in Extracted Tailings

%

6.8

Total Mined Iron

Mt

7.0

LOM

Years

15

Extraction Cost - OPEX

US$/t

0.65

Process Cost - OPEX

US$/t

1.56

Anticipated Average Concentrate Grade

%

66.8

Mining

The Project involves the extraction and reprocessing of the Lac Jeannine tailings based on an extraction rate of 7 Mtpa to produce on average 360 Ktpa of concentrate for 15 years. Based on the study to date, the concentrate is expected to be a premium grade product containing 66.8 % FeT with very low concentrations of deleterious elements such as SiO2, P and Al2O3.

It is anticipated that the rejects from the reprocessing of the tailings will be pumped back into the former Lac Jeannine mine open pit so that the natural topography can, as much as possible, be returned to its natural state.

Whilst the 2026 Inferred Resource is currently restricted to approximately 104 Mt (102.3 Mt is mineable) of material it is recognized that there is additional material present outside of the drill tested area. This material is classified as an exploration target and is presented as a range of grade and tonnes in this PEA study. Any material which is classified as part of the exploration target is treated as waste and stockpiled for the purpose of the 2026 PEA and is not considered as payable material in financial analysis.

The Project design is relatively simple as the tailings pile forms a dome shape with an aerial extent of approximately 1.8 x 1.6 km and an estimated depth of up to 70 m at the central highest point. The 2026 Inferred Mineral Resource is currently restricted to an aerial extent of approximately 1.25 km x 1.40 km with thickness of approximately 50 m to 60 m.

There is a natural gradation in grade from high to low in the tailings pile, which means that the Inferred Resource can be extracted level by level (top to bottom) to eventually form a saucer shaped depression with a depth of up to 60 m from the existing tailings high point and a resultant maximum pit depth of 45 m (Figure 2). Grade variation is observed in the Project schedule as a linear reduction from approximately 8.5% FeT to 7.4 % FeT in the first 3 years of production, grade further reducing to approximately 6.5% FeT by year 10 and subsequently 5.8% FeT in the final year reflecting the vertical variation seen in the Resource block model.

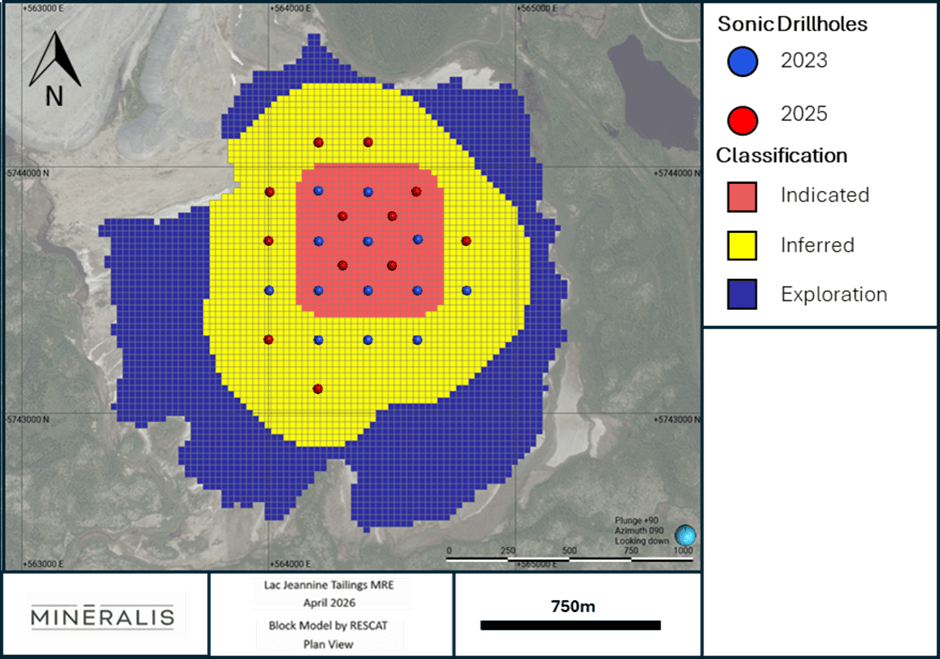

Figure 2: Optimized Pit limits based on Inferred Resources

The maximum extents of the pit were determined through pit optimization of the block model. Each block was allocated an economic value based on the revenue and costs and all blocks with a positive value were sent for processing. The economic breakeven cut-off grade was found to be 3.4 % FeT.

Given there is no surface waste covering (organic material or low grade) it is expected that 100% of the 2026 MRE within the optimized pit limit can be re-processed as the grade of the blocks are all above the economic cut-off grade. The average grade for the Inferred material was 6.8 % FeT.

The proposed mining and material transport method combines a load and carry operation with conveyor-based material transport from the mining area to the concentrator plant. Two front-end loaders excavate the soft, iron-bearing tailings directly at the mining face and carry it over relatively short distances to a belt-feeder hopper. The hopper, mounted on a shiftable bench conveyor, transforms the discontinuous batch feed from the loaders into a continuous material stream for onward conveying to the plant. The bench conveyor can be track-shifted to follow the advance of the mining face: as a mining strip is depleted and the loader travel distances become inefficient, the bench conveyor and hopper are shifted closer to the active mining face.

The deposit is mined bench-by-bench from top to bottom, with bench heights of approx. 5 m to 6 m. Each bench is progressively depleted by radially track-shifting the bench conveyor across the entire deposit area. The head end of the bench conveyor remains fixed near the pit exit, transferring the mined material onto the downstream conveyor towards the concentrator plant. Each track-shift position of the bench conveyor releases a new mining strip for the front-end loaders to excavate.

The average mining rate of 7 Mtpa equates to approximately 1,000 tph to 1,250 tph based on an annual equipment utilization time of 6,500 hours. This can be achieved with two loaders (approx. 9 m³ to 10 m³ buckets each) and a single conveying line, provided the carry distance to the belt feeder hopper stays below 100 m. A Dozer is employed as auxiliary equipment for conveyor track-shifting as well as activities related to pit floor maintenance and bench slope trimming/flattening.

It is expected that the extraction operation can continue throughout the year and material handling issues can be minimized by the rapid turnover of the faces (i.e. prevents permafrost forming). Although the material can become compacted, it is generally relatively dry and self-draining by virtue of the dome shape of the deposit. The digging conditions are not expected to be challenging, but the high silica content will mean that it is highly abrasive.

For the purpose of the 2026 PEA, 2.3 Mt of material that is within the pit limit and is classified as exploration target or waste. The exploration target material will be stockpiled near to the plant. If the exploration material can be shown to be economic through sampling, then it will be processed along with the Inferred material. It was not, however, considered in the 2026 PEA as payable material.

It is also pragmatic to consider the impact on the Project schedule and waste disposal requirements should all of the exploration target material (circa. 40 Mt) be converted to a Mineral Resource. Were this to happen the addition of the exploration target material is unlikely to significantly change the sequence of extraction from a top-down approach, while it will mean the pit can be taken to the extents of the deposit, and this eliminates the formation of the saucer shaped pit.

This will have advantages in terms of slope stability and ease of rehabilitation of the whole of the tailings area. It may also offer potential for an extended period of higher-grade feed in the early years, on the assumption that the higher-grade material seen at the top of the Inferred Mineral Resource extends towards the edge of the tailings. It is envisaged that waste material from the processing facility will be disposed of in the legacy Lac Jeannine open pit. It is estimated there is adequate space present to accommodate processing waste material from both the Mineral Resource and exploration target material.

Capital Costs

Initial CAPEX costs for the Project are based on a ROM of 7 Mtpa with a nominal production capacity of circa. 400 ktpa of 66.8% FeT concentrate. CAPEX costs are estimated at US$69.4M, including EPCM costs and a 15% contingency based on the processing plant and EPCM CAPEX figures.

Sustaining capital over the Project life is estimated at 1.5% of OPEX (excluding G&A) and closure cost is estimated at 5% of total CAPEX, resulting in total life of mine CAPEX cost of US$76.8M.

Table 4: Capital Costs

Description

US$ (M)

Processing Plant

44.2

Infrastructure

4.5

Extraction

6.8

Indirect Costs (EPCM)

6.3

Estimated Sub-Total Cost

61.8

Contingency 15%

7.6

Sustaining

3.9

Closure cost

3.5

Estimated Total Cost

76.8

Operating Costs

The OPEX includes manpower to run the overall operations, and sub-contracted maintenance teams, power and utilities, materials handling, transport of the concentrate from the Project site to the port and G&A.

Table 5: Operating costs

Area

US$/t ROM

US$/t concentrate

Tailings extraction (incl. tailings disposal)

0.65

12.46

Processing

1.56

29.67

Transport all in to port

0.33

6.32

G&A

0.25

4.72

Royalty (0.5% of revenue)

0.033

0.62

Total OPEX

2.82

53.79

Economic Analysis and Sensitivity

Table 6: Economic Results

Economic Assumptions

Unit

P65 Index CFR China Iron ore price

US$/dmt

121

Average realised price (Inc. high grade premium)

US$/dmt

145

Freight

US$/wmt

21

Pre-Tax NPV at 7% discount rate

US$M

141.5

Pre-Tax IRR

%

33.8

Post-Tax NPV 7% discount rate

US$M

91.9

Post-Tax IRR

%

29.6

Payback

years

2.3

PI

1.2

A sensitivity analysis was performed whereby initial infrastructure capital cost, annual operating costs and product selling price were individually varied between +/-15% to determine the impact on Project IRR and NPV at a 7.0 % discount rate.

Results are presented in Table 7, as well as graphically in Figure 4 and Figure 5. The Project financials are most sensitive to the commodity selling price followed by operating costs and finally initial capital expenditures.

Table 7: Sensitivity Analysis (US$,000)

Base Case

CAPEX

Selling price (FOB)

LOM OPEX

15%

-15%

15%

-15%

15%

-15%

IRR

29.6%

25.9%

34.0%

35.6%

22.5%

28.1%

30.9%

NPV

0%

$197,319

$191,528

$202,658

$262,769

$136,227

$182,827

$211,553

5%

$114,088

$108,207

$119,484

$155,350

$74,817

$104,995

$122,984

7%

$91,933

$86,025

$97,356

$126,830

$58,431

$84,248

$99,438

10%

$66,354

$60,425

$71,805

$93,945

$39,503

$60,280

$72,273

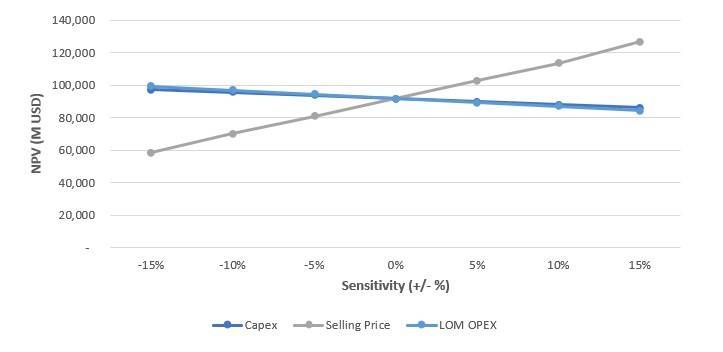

Figure 4: NPV Sensitivity Analysis Graph

Figure 5: IRR Sensitivity Analysis Graph

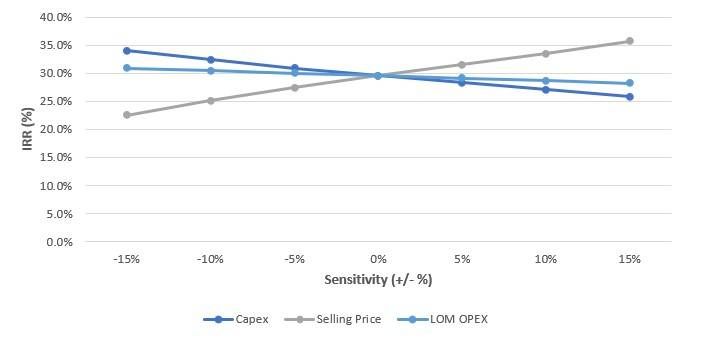

Future Work

Work to be carried out in parallel with the FS include:

  • Inferred to Indicated Resources: Additional drilling, planned for 2027, will aim to increase the total resource figure further and convert an additional 40 Mt from inferred to indicated with a target of total indicated mineral resource to approximately 70 Mt.

  • Metallurgy testing: Incorporation of the Salter MGS technology into the recovery circuit to recover ultra fine iron which may be lost to tailings; this test work will commence once the final flowsheet has been confirmed.

  • Low grade waste piles: Investigate the economic opportunity of processing low grade waste piles located on site.

  • Tailings management: Investigate potential uses for the high-grade silica tailings that will be produced following the iron recovery; potential uses may be concrete production or for road construction.

  • Transport: Advance discussions for the potential use of the Cartier railway for transportation of the concentrate from the Lac Jeannine rail spur to the port.

  • Infrastructure and Services: Investigate potential for constructing solar/wind power supply for the site.

  • Financing: Continue discussion with potential strategic partners to support the Project financing.

  • Economic support from Federal and Provincial governments: Explore potential for economic support from governments, funding opportunities and other economic incentives for the Project, including those aiming to encourage the development of critical minerals and a circular economy.

The Lac Jeannine Project

The Lac Jeannine property comprises a contiguous block of thirty-one (31) mineral claims - now referred to in Québec as exclusive exploration rights ("EER") - covering an aggregate of 1,649.34 hectares (ha) in the Caniapiscau regional county municipality (RCM) of the Côte-Nord Region of eastern Québec, approximately eight km southeast of the abandoned town-site of Gagnon and 290 km north of the City of Baie-Comeau.

The Project encompasses the former Lac Jeannine open pit mine, from which approximately 260 million long tons of ore at 33% iron, in mainly specular hematite form, was extracted between 1961 and 1976. The Property also covers the tailings pile where "waste" from the on-site ore concentrator were deposited. In 1984, the Lac Jeannine mining and processing facilities were shut down and the mine site rehabilitated; however, the historical tailings were not reclaimed.

CoTec's focus is on the tailing's material, planned to be re-processed for residual iron, and rehabilitate the site to as close to its natural state as practically possible.

The EER comprising the Project are registered 100% to Patricia Lafontaine. On August 9, 2023, CoTec announced that it had entered into an option agreement (the "Option Agreement") to acquire 100% of the right, title, and interest of the EER comprising the Project.

Pursuant to the Option Agreement, CoTec agreed to pay the vendor, US$250,000 on exercise of the option and US$1,000,000 at the start of commercial extraction of the tailings. CoTec may exercise its option to acquire the EER at any time until the earlier of (i) 15 business days after the issuance of all material permits required to construct and operate the Project and (ii) August 7, 2033. If the option is exercised, the vendor will also receive a 1% net smelter royalty (NSR) from the sale of minerals from the historical tailings and a 1.5% NSR from the sale of other minerals from the Project. The 1% NSR and 1.5% NSR could each be reduced, at CoTec's option, by half through the payment of US$1,000,000 and US$2,000,000 respectively.

Qualified Persons and Data Verification

The independent Qualified Persons as defined by NI 43-101, are Mr. Christian Beaulieu, P.Geo. of Mineralis Consulting Services Inc for Mineral Resources and Exploration Target; Mr John Langton P.Geo. of JPL GeoServices Inc. for Mineral Exploration; Mr Matthew Randall of Axe Valley Mining Consultants Ltd. for Mining; Daniel Roy P.Eng. of Soutex for Processing; Martin Errington P.Eng. of Amerston Consulting Limited for Infrastructure and Services, Capital Costs, Operating Costs and Economic Analysis and Sensitivity.

The Qualified Persons have reviewed and approved the scientific and technical content of this news release.

About CoTec

CoTec is a publicly traded investment issuer listed on the TSX Venture Exchange ("TSX- V") and the OTCQB and trades under the symbols CTH and CTHCF, respectively. The Company is an environment, social, and governance ("ESG")-focused company investing in innovative technologies that have the potential to fundamentally change the way metals and minerals can be extracted and processed for the purpose of applying those technologies to undervalued operating assets and recycling opportunities, as the Company transitions into a mid- tier mineral resource producer.

CoTec is committed to supporting the transition to a lower carbon future for the extraction industry, a sector on the cusp of a green revolution as it embraces technology and innovation. The Company has made four investments to date and is actively pursuing operating opportunities where current technology investments could be deployed.

For further information, please contact:
Braam Jonker - (604) 992-5600

Forward-Looking Information Cautionary Statement
Statements in this press release regarding the Company and its investments which are not historical facts are "forward-looking statements" which involve risks and uncertainties, including statements relating to the 2026 PEA, 2026 MRE, the Lac Jeannine Project and any implied or stated benefit that might flow to the Company relating to Lac Jeannine Project, as well as management's expectations with respect to its other current and potential future investments and the benefits to the Company which may be implied from such statements. Since forward-looking statements address future events and conditions, by their very nature, they involve inherent risks and uncertainties. Actual results in each case could differ materially from those currently anticipated in such statements, due to known and unknown risks and uncertainties affecting the Company, including but not limited to resource and reserve risks; environmental risks and costs; labour costs and shortages; uncertain supply and price fluctuations in materials; increases in energy costs; labour disputes and work stoppages; leasing costs and the availability of equipment; heavy equipment demand and availability; contractor and subcontractor performance issues; worksite safety issues; project delays and cost overruns; extreme weather conditions; and social and transport disruptions. For further details regarding risks and uncertainties facing the Company please refer to "Risk Factors" in the Company's filing statement dated April 6, 2022, a copy of which may be found under the Company's SEDAR profile at www.sedar.com. The Company assumes no responsibility to update forward-looking statements in this press release except as required by law. Readers should not place undue reliance on the forward-looking statements and information contained in this news release and are encouraged to read the Company's continuous disclosure documents which are available on SEDAR at www.sedarplus.ca.

Neither TSX Venture Exchange nor its Regulation Services Provider (as that term is defined in the policies of the TSX Venture Exchange) accepts responsibility for the adequacy or accuracy of this news release.

i https://www.cotec.ca/news/cotec-completes-infill-and-expansion-resource-drilling-programme-at-the-lac-jeannine-project-engages-corem-for-metallurgical-testing-and-commences-a-process-to-appoint-an-epcm-provider-for-the-feasibility-study
ii https://www.cotec.ca/news/cotec-files-preliminary-economic-assessment-and-technical-report-for-the-lac-jeannine-iron-tailings-project-qubec-canada
iii The profitability index is a measure of the capital efficiency of a project and is defined as the project's NPV divided by the project capital including the capital incurred to reach first run of production.
iv Economic assumptions were kept the same as those from the 2024 PEA.
v Quinto Mining Corporation- Opportunity Study Beneficiation of the Lac Jeannine Tailings - Release 1, July 2007

SOURCE: CoTec Holdings Corp.



View the original press release on ACCESS Newswire

News Provided by ACCESS Newswire via QuoteMedia

CTH:CC
CoTec Holdings

CoTec Holdings Investor Kit

  • Corporate info
  • Insights
  • Growth strategies
  • Upcoming projects

GET YOUR FREE INVESTOR KIT

The Conversation (0)
CoTec Holdings (TSXV:CTH)

CoTec Holdings

Investor Insight

CoTec Holdings combines proprietary processing technologies with undervalued and legacy resource assets to create high-margin opportunities across rare earths, iron and copper sectors. With three execution-stage projects and a significant discount to attributable NAV, CoTec provides differentiated exposure to strategic minerals tied to electrification, AI infrastructure and supply-chain security.

Overview

CoTec Holdings (TSXV:CTH, OTCQX:CTHCF) is redefining the future of rare earth magnet recycling and strategic material extraction. Its portfolio spans rare earth magnet recycling, iron tailings reprocessing and emerging copper extraction technologies, all directed at fast-tracking revenue generation and reducing energy and capital intensity compared to conventional mining.CoTec Holdings mining model

Key Technologies

The company’s modular, capital-efficient model — including joint ventures and strategic subsidiaries — positions it for scalable growth and streamlined execution. With significant advancement in project execution, two completed feasibility studies, a third underway and an independent pre-feasibility study for HyProMag USA’s U.S. expansion completed in October 2026, CoTec is moving toward transforming its technology suite into commercial operations.

Why Invest in CoTec?

Why invest in CoTec Holdings

  • Differentiated Growth Model: Capital-light strategy deploying modular technologies at brownfield assets to accelerate timelines and reduce capital intensity.
  • Strategic Commodity Exposure: Exposure to rare earths, iron and copper — key materials for electrification, AI infrastructure, robotics and other critical supply chains.
  • Execution-Stage Portfolio: Three projects advancing through feasibility, engineering and financing stages.
  • Aligned Leadership: Strong insider ownership and experienced management with deep mining and capital markets expertise.
  • Lower-Carbon Production: Technologies designed to reduce energy use, water consumption and emissions relative to conventional mining.

Company Highlights

  • Technology-Driven Value Creation: Deploys proprietary, low-carbon processing technologies to extract value from waste, tailings and marginal deposits that traditional mining overlooks.
  • Execution-Stage Projects: Advancing three core assets — HyProMag USA magnet recycling, the Lac Jeannine iron tailings project, and MagIron iron ore feedstock, concentrator and pelletizer — with clear development pathways.
  • Expanding Rare Earth Footprint: HyProMag USA advances its scalable US hub-and-spoke rare earth magnet recycling roll-out using the Hydrogen Processing of Magnetic Scrap (“HPMS”) technology, with Inserma HDD pre-processing machines installed in South Carolina and Nevada and power secured for the Texas Hub. An independent Pre-Feasibility Study (October 2026) outlines a four-plant U.S. platform that would roughly quadruple planned magnet capacity to approximately 4,192 metric tons per year by 2034.
  • Strategic Copper Focus: Established a new subsidiary, CoTec Copper, to accelerate targeted investment in copper tailings and copper sulfide deposits globally, leveraging CoTec’s core technologies to unlock value.
  • Iron Ore & Green Steel: Advancing iron tailings reprocessing at Lac Jeannine and supporting the restart of MagIron in Minnesota and Indiana, which is now advancing merchant pig iron as its primary development strategy while retaining DR-grade pellet optionality, to supply high-grade feedstock for low-carbon steel production.
  • Strong Insider Support: Insiders own approximately 58 percent of shares, reinforcing alignment with long-term value creation.
  • Experienced Leadership: Board and executives bring deep mining, technology and capital markets experience from leading global organizations.

Key Technologies and Assets

HyProMag USA Projec

HyProMag USA project

HyProMag USA is CoTec’s flagship rare earth recycling platform and a cornerstone of its strategy to localize critical mineral supply chains. The project deploys Hydrogen Processing of Magnetic Scrap technology to recover neodymium iron boron magnets from end-of-life electronics and industrial equipment through a simplified hydrogen-based process that bypasses traditional chemical separation and smelting. This short-loop approach dramatically reduces energy use, water consumption and emissions while lowering operating complexity and cost.

The company’s phased development plan is targeting commissioning of its initial neodymium-iron-boron magnet cutting and finishing operations in Texas in H1 2027, with Phase 1 of the integrated Northlake, Texas recycling and magnet manufacturing facility targeted for completion in mid-2028. Up to 20 tonnes of magnet blocks supplied by HyProMag Group in the United Kingdom and Germany will be shaped and finished at HyProMag USA's operations for U.S. customers. Power capacity for the Texas Hub has been secured with Oncor, expected to be supplied predominantly from renewable energy, and contractor selection and permitting are underway. In October 2026, an independent Pre-Feasibility Study by PegasusTSI and BBA USA outlined an expansion to three additional plants and a Central Texas Hub, taking the platform to approximately 6,000 metric tons per year of salable material by 2034.

Watch an overview of HyProMag USA here: https://www.youtube.com/watch?v=v0d7rKdwu_s

Highlights

  • CoTec holds a 60.3 percent economic interest.
  • Northlake, Texas facility post-tax NPV of approximately US$723 million at forecast prices (October 2026 update to the 2024 Feasibility Study, reflecting detailed engineering and finalized equipment orders).
  • Northlake capital cost estimated at approximately US$167 million (AACE Class 2), with Phase 1 targeting about 1,034 metric tons per year of payable production and Phase 2 about 1,526 metric tons per year.
  • Initial magnet cutting and finishing operations, and first U.S. magnet sales, targeted for H1 2027.
  • Independent Pre-Feasibility Study (October 2026) indicates an incremental post-tax NPV of US$1.85 billion to US$2.06 billion and post-tax IRR of 31 to 36 percent for three additional plants and a Central Texas Hub, at a capital cost of approximately US$623 million to US$656 million; combined with Northlake, platform post-tax NPV of US$2.6 billion to US$2.8 billion and NdFeB magnet capacity of approximately 4,192 metric tons per year by 2034.
  • Inserma pre-processing machines have been installed at South Carolina and Nevada facilities to support feedstock preparation and scale-up of the hub-and-spoke rollout.
  • Integrated Texas Hub’s Hydrogen Processing of Magnet Scrap section targeted for mid-2028.
  • HyProMag GmbH, the HyProMag Group’s German operation in Pforzheim, was designated a Strategic Project under the EU Critical Raw Materials Act in October 2026, underscoring the strategic relevance of the HPMS technology.

Lac Jeannine Iron Project

CoTec Holdings Lac Jeannine Iron project

The Lac Jeannine project is an advanced tailings reprocessing initiative designed to transform legacy mining waste into high-purity iron concentrate for steelmaking. By leveraging existing infrastructure and modern processing technologies, the project aims to unlock value from previously discarded material while simultaneously advancing environmental reclamation. This approach aligns economic return with environmental remediation and supports domestic iron supply.

Metallurgical test work has demonstrated the project's ability to produce a high-purity iron concentrate grading in excess of 67 percent FeT, the threshold for high-purity iron under the Québec and Canadian critical and strategic minerals frameworks. CEO Julian Treger said that this validates the resource’s quality and the effectiveness of the company’s processing strategy. “(It also supports) our vision of transforming a historic environmental liability into a strategic asset capable of supporting the global transition to lower-carbon steel production."

Highlights

  • Indicated resource of about 31 Mt at 6.8 percent iron and inferred resource of about 71 Mt at 6.8 percent iron (2026 MRE).
  • After-tax NPV7 of US$91.9 million and IRR of 29.6 percent (2026 PEA).
  • Initial capex estimated at US$69.4 million.
  • 15-year mine life
  • A 41 percent increase in the resource according to the 2026 PEA, with a global increase in total iron grade from 6.7 to 6.8 percent.
  • Feasibility Study underway with BBA Consulting, with permitting and offtake discussions in progress.

MagIron represents a restart-ready brownfield iron ore deposit, concentrator and pelletizer project in Minnesota and Indiana, that benefits from an estimated $660m in historical capital investment, targeting the production of direct-reduction grade pellets for low-carbon steelmaking. The project benefits from extensive existing infrastructure and prior capital investment, allowing rapid recommissioning compared with greenfield developments. Its strategic positioning targets rising demand for domestically sourced feedstock for electric arc furnaces and decarbonized steel production.

Senior leadership changes have been made to support the ongoing development of MagIron, especially regarding restarting its iron ore concentrator in Minnesota and pellet plant in Indiana. In August 2026, a concept study by Primetals Technologies confirmed three technically credible pathways to produce approximately 2 million tonnes per year of granulated pig iron at MagIron’s facilities. MagIron is now advancing pig iron as its primary development strategy while retaining DR-grade pellet optionality, and independent test work at the Natural Resources Research Institute confirmed that MagIron concentrate can produce DR-grade pellets.

Highlights

  • CoTec owns approximately 17 percent.
  • Definitive Feasibility Study shows after-tax NPV of about US$1.60 billion and IRR about 27.6 percent.
  • Average annual production is about 2.6 Mt DR-grade pellets.
  • Life of mine is about 32 years.
  • Payback period is about 3 years and 7 months.
  • Mine and concentrator permits in place; pellet plant permitting in progress
  • Raised additional capital at a pre-money valuation of US$550 million from existing shareholders

CoTec Copper

CoTec Copper is a dedicated subsidiary created to accelerate the company’s exposure to copper, one of the most strategically important electrification metals. The unit focuses on acquiring and advancing copper tailings projects and sulphide deposits, particularly in historically productive mining jurisdictions where modern processing technologies can unlock additional value from previously uneconomic material. It leverages CoTec’s existing technology portfolio to enhance recoveries and lower operating costs.

Highlights

  • Targets assets in Tier 1 mining regions across the United States, Australia, Latin America and Africa.
  • Focuses on both tailings reprocessing and sulphide copper deposits.
  • Designed as a scalable growth platform to expand CoTec’s copper exposure.
  • Definitive joint venture shareholder agreement with Copper Intelligence (September 2026) to pursue historical copper tailings opportunities in the Democratic Republic of Congo, with funding to be sought from the U.S. International Development Finance Corporation and other sources once sufficient scale is achieved.
  • Non-binding framework agreement with Battery Mineral Resources (October 2026) toward a Strategic Economic Joint Venture at the Punitaqui copper mining district in Chile.

Binding Solutions

Binding Solutions provides a cold agglomeration technology that converts ultrafine mineral waste into ISO-compliant pellets or briquettes suitable for industrial use, particularly in green steel production. Unlike traditional pelletizing processes that rely on high-temperature furnaces, this approach operates at low temperatures, drastically reducing energy consumption and emissions while enabling monetization of low-grade or waste materials.

Highlights

  • Uses about 95 percent less energy than conventional pelletizing.
  • Generates about 98 percent fewer emissions.
  • Applicable to iron and other mineral fines.

Ceibo

Ceibo’s oxidative heap-leaching technology is designed to improve copper recovery from sulphide ores such as chalcopyrite, which account for the majority of global copper reserves but are traditionally difficult and costly to process. The process enhances recovery rates while lowering environmental impact and capital intensity, potentially transforming the economics of many existing copper assets.

Highlights

  • Potential recovery improvement from about 30 percent to approximately 75 percent.
  • Targets refractory sulphide deposits often considered uneconomic.
  • CoTec holds a minority equity interest and a seat on the technical advisory board.
  • Completed Series B financing of over US$30 million led by Energy Impact Partners to fund the scaling of the technology.
  • Investor syndicate includes BHP Ventures. Ceibo has partnered with Glencore’s Lomas Bayas operation in Chile (2024) and produced first copper cathodes at a demonstration plant with Compañía Minera San Gerónimo (2025).

WaveCracker

WaveCracker is a microwave-assisted mineral processing technology being advanced in collaboration with McGill University. The system uses targeted microwave energy to weaken mineral structures before conventional processing, improving metal liberation, reducing reagent consumption and lowering overall processing costs.

Highlights

  • Focused initially on copper sulphide applications.
  • Designed to accelerate leaching and recovery kinetics.
  • Builds on more than 30 years of microwave mineral processing research.

Salter Cyclones

Salter Cyclones technology uses multi-gravity separators to recover ultra-fine minerals from tailings streams that traditional processing methods cannot efficiently capture. By enabling recovery of metals from waste material, the system creates new revenue streams while reducing environmental liabilities associated with tailings storage.

Highlights

  • Applicable to iron, manganese and other fine mineral commodities.
  • Exclusive global rights for iron applications and regional exclusivity for manganese during the initial agreement period.
  • Converts waste into high-grade concentrates suitable for market.
  • CoTec-owned commercial-scale SCMG2 unit under assembly in the UK, with factory acceptance testing from Q3 2026, for deployment at Corem in Québec as a commercial testing and demonstration platform supporting Lac Jeannine and third-party iron ore opportunities.

Management Team

Julian Treger - Chief Executive Officer and Director

Julian Treger previously served as the CEO of Anglo Pacific Group before establishing Audley Capital Partners. At Audley, Treger directed the team through acquisitions totaling $570 million and achieved a realized Internal Rate of Return (IRR) of 38 percent. Treger continues to serve as the chairman of Audley Capital and holds both a BA and an MBA from Harvard.

Abraham Jonker - Chief Financial Officer

Abraham Jonker has 30 years of experience in mining finance. He previously served as the Lead Independent Director at Mandalay Resources and has been instrumental in leading over $750 million in equity and debt raises. Jonker is a Chartered Accountant in the UK, Canada, and South Africa and holds a Master's in Tax from Rand Afrikaans University.

John Singleton - Chief Operating Officer

John Singleton possesses over 25 years of experience in mining. His career began at De Beers, and he has since held senior leadership roles at Centamin and Rio Tinto. Singleton is a Fellow of the Royal Geological Society and holds degrees from Imperial College London and the University of Bristol.

John McGagh - Technology Consultant

John McGagh has more than 35 years of experience in digital transformation across various industries. He served as the head of innovation at Rio Tinto and is currently the chief digital officer at Snowy Hydro. McGagh is an adjunct professor at the University of Queensland and a Fellow of the Australian Academy of Technology Science and Engineering.

Eugene Hercun - VP Finance & Investor Relations

Eugene Hercun is a CPA, CA, with 15 years of varied experience in mining finance. He has led metal sales negotiations for more than $200 million annually and holds Level 1 of the CFA designation.

Hugh Thatcher - VP North America

Hugh Thatcher has 25 years of experience as in-house counsel in the mining and industrial sectors, including as Chief Counsel - US at Rio Tinto from 2020 to 2023. He holds a BA from Whitman College and a JD from Vanderbilt University.

Ian French - VP Projects

Ian French has more than 20 years of experience in project delivery and risk advisory across diamonds, gems and precious metals, including as Global Head of Diamond Risk & Security at Rio Tinto, and has led major infrastructure programs for mining companies and governments.

Board of Directors

Lucio Genovese, Independent Chairman

Lucio Genovese currently serves as the CEO of Nage Capital and as the chairman of Ferrexpo plc. He previously held senior roles at Glencore, including CEO of the CIS region. Genovese is a Chartered Accountant with degrees in Commerce and Accounting from the University of Witwatersrand.

Tom Albanese, Non-executive Director

Tom Albanese is the former CEO of Rio Tinto and Vedanta Resources. He was appointed Chair of Franco-Nevada Corporation in May 2026, having served as a director since 2013, and previously served as lead independent director of Nevada Copper. Albanese holds Master's and Bachelor's degrees from the University of Alaska Fairbanks.

Robert (Bob) Harward - Non-Executive Director

Robert Harward is a retired US Navy Vice Admiral (SEAL) and former deputy commander of US Central Command. He served on the US National Security Council and held senior strategy roles at Lockheed Martin and Shield AI.

Erez Ichilov - Non-executive Director

Erez Ichilov previously served as managing director at Traxys Projects, where he led investments in companies such as Nouveau Monde Graphite, Talon Metals, and Li-Cycle. Ichilov holds LLB and MBA degrees.

Sharon Fay - Non-executive Director

Sharon Fay previously served as head of equities and head of responsibility at AllianceBernstein. She built the firm's Corporate Responsibility and Responsible Investment teams. Fay is a Chartered Financial Analyst with a BA from Brown and an MBA from Harvard.

Metalsource Mining Receives $1.38 Million from Eric Sprott Warrant Exercise as Silver Hill Gold-Silver Exploration Advances

Metalsource Mining Receives $1.38 Million from Eric Sprott Warrant Exercise as Silver Hill Gold-Silver Exploration Advances

Eric Sprott now holds approximately 19.9% of outstanding shares, as proceeds strengthen Metalsource's treasury to advance aggressive expansion drilling and larger stepouts investigating the potential scale of the Silver Hill polymetallic system in North Carolina.Metalsource Mining Inc. (CSE:... Keep Reading...
America May Be Sitting on a Gold and Silver Fortune Hiding in Plain Sight

America May Be Sitting on a Gold and Silver Fortune Hiding in Plain Sight

MiningNewsWire Editorial Coverage: With U.S. debt climbing above 100% of GDP while central banks are still accumulating gold, investors are once again seeking safety in silver and gold. Zinc, lead, copper and silver, meanwhile, all now appear on the 2025 List of Critical Minerals published by... Keep Reading...
Eric Sprott Announces Changes to His Holdings in Metalsource Mining Inc.

Eric Sprott Announces Changes to His Holdings in Metalsource Mining Inc.

Eric Sprott announces that on November 17, 2026, 2176423 Ontario Ltd. (a corporation he beneficially owns) exercised 3,750,000 common share purchase warrants (Warrants) of Metalsource Mining Inc., at $0.30 per common share (Share) and 637,158 Warrants at $0.40 per Share for aggregate... Keep Reading...
Noble Engages Stephen Balch As Strategic Advisor

Noble Engages Stephen Balch As Strategic Advisor

(TheNewswire) Toronto, Ontario November 18, 2026 TheNewswire - Noble Mineral Exploration Inc. ("Noble" or the "Company") (TSX-V:NOB, FRANKFURT: NB7, OTCQB:NLPXF) is pleased to announce that it is engaging Stephen Balch, through his consulting company, as a Strategic Advisor. "We have had a long... Keep Reading...
Renforth Completes Updated Mineral Resource Estimate On Wholly Owned Parbec Gold Deposit In Malartic, Quebec

Renforth Completes Updated Mineral Resource Estimate On Wholly Owned Parbec Gold Deposit In Malartic, Quebec

(TheNewswire) TORONTO, Ontario — November 18, 2026 TheNewswire — Renforth Resources Inc. (CSE: RFR,OTC:RFHRF | OTC: RFHRF | FSE: 9RR) ("Renforth" or the "Company") is pleased to advise shareholders that P&E Mining Consultants Inc. ("P&E") have completed an updated Mineral Resource Estimate... Keep Reading...
Getty Copper Receives Dot Property Drill Permit and Initiates Geophysical Survey

Getty Copper Receives Dot Property Drill Permit and Initiates Geophysical Survey

HighlightsDrill permit received for the Dot PropertyInduced polarization (IP) geophysical survey commenced1.2 km long copper trend is open for expansion under coverHistorical drill intercepts include 76 m of 0.91% Cu at the North Zone and 101 m of 0.55% Cu at the South ZonePlanning underway for... Keep Reading...
CoTec Holdings

CoTec Holdings Investor Kit

  • Corporate info
  • Insights
  • Growth strategies
  • Upcoming projects

GET YOUR FREE INVESTOR KIT

Interactive Chart

Latest Press Releases

Related News
